Planning a bathroom renovation but wondering how long to refit a bathroom from start to finish? You’re not alone in asking this crucial question. Whether you’re dealing with family schedules, work commitments, or simply need to know when you’ll have your bathroom back, understanding the realistic timeframe for a complete bathroom refit is essential for proper planning. From initial demolition to final tile grouting, we’ll break down every stage so you know exactly what to expect and can plan accordingly.
Why Does Bathroom Refit Duration Matter for UK Homeowners?

Source : Checkatrade
Understanding how long a bathroom refit takes affects every aspect of your renovation project. When you’re living through the disruption of a major home improvement, timing becomes everything. Most UK families find themselves juggling work schedules, school runs, and daily routines whilst managing the inconvenience of a torn-apart bathroom.
Planning around family schedules and daily routines
Your bathroom serves as the central hub for morning routines and evening wind-downs. When this space becomes unavailable, every family member feels the impact. Children need reliable access for school preparation, whilst working adults require predictable schedules for their daily commute. Planning your refit around school holidays or quieter work periods can significantly reduce stress for the entire household. Many families choose to stay with relatives or arrange temporary shower facilities during major renovation work.
Budget implications of extended bathroom refit timelines
- Additional accommodation costs if the refit extends beyond expected timeframes
- Potential storage fees for bathroom fixtures and personal items
- Lost productivity from time spent managing the renovation process
- Increased labour costs if delays require extended contractor engagement
Managing expectations with contractors and suppliers
Clear communication about timing expectations helps maintain positive relationships with your renovation team. Professional tilers and contractors appreciate clients who understand realistic timeframes and plan accordingly. Setting buffer periods of 20-30% beyond quoted completion dates protects against disappointment when unexpected issues arise during the refit process.
What Factors Determine How Long Your Bathroom Refit Takes?

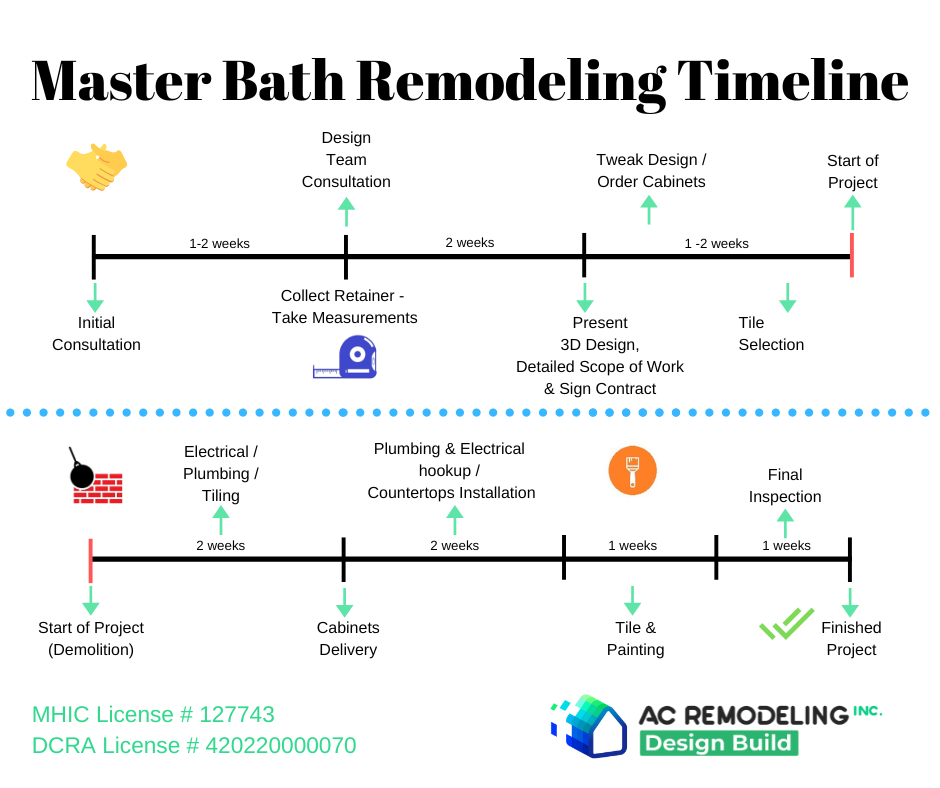

Source : AC Remodeling
Multiple variables influence the duration of your bathroom renovation project. Understanding these factors helps you make informed decisions about scope, timing, and contractor selection. Each element contributes to the overall timeline in different ways.
Size and complexity of your existing bathroom space
Compact shower rooms typically require 3-5 working days for a complete refit, whilst larger family bathrooms with separate shower enclosures can extend to 8-10 working days. Victorian terraced houses often present unique challenges with awkward layouts and limited access, potentially adding 2-3 days to the overall timeline. Modern homes with standard fittings generally allow for more predictable scheduling.
Extent of structural changes and plumbing modifications
- Moving toilet locations requires new waste pipe installation
- Relocating showers involves significant plumbing and waterproofing work
- Wall removal or addition needs structural assessments and building regulations approval
- Electrical upgrades for heated towel rails or extractor fans add complexity
Quality and availability of tiles and materials
Premium natural stone tiles often require longer installation periods due to careful handling and specialised cutting requirements. Porcelain and ceramic tiles typically install faster whilst maintaining excellent durability for family bathrooms. Import delays can extend project timelines by several weeks, particularly for bespoke or designer tile collections.
Professional tilers versus DIY approach impact on refit duration
Experienced tilers complete installations significantly faster than DIY approaches. Professional teams bring specialised tools, proven techniques, and efficient workflows that reduce installation time by 50-70% compared to amateur attempts. However, DIY refits allow flexible scheduling around personal commitments, though they typically extend over several weekends or evenings.
How Long Does a Standard Bathroom Refit Take?

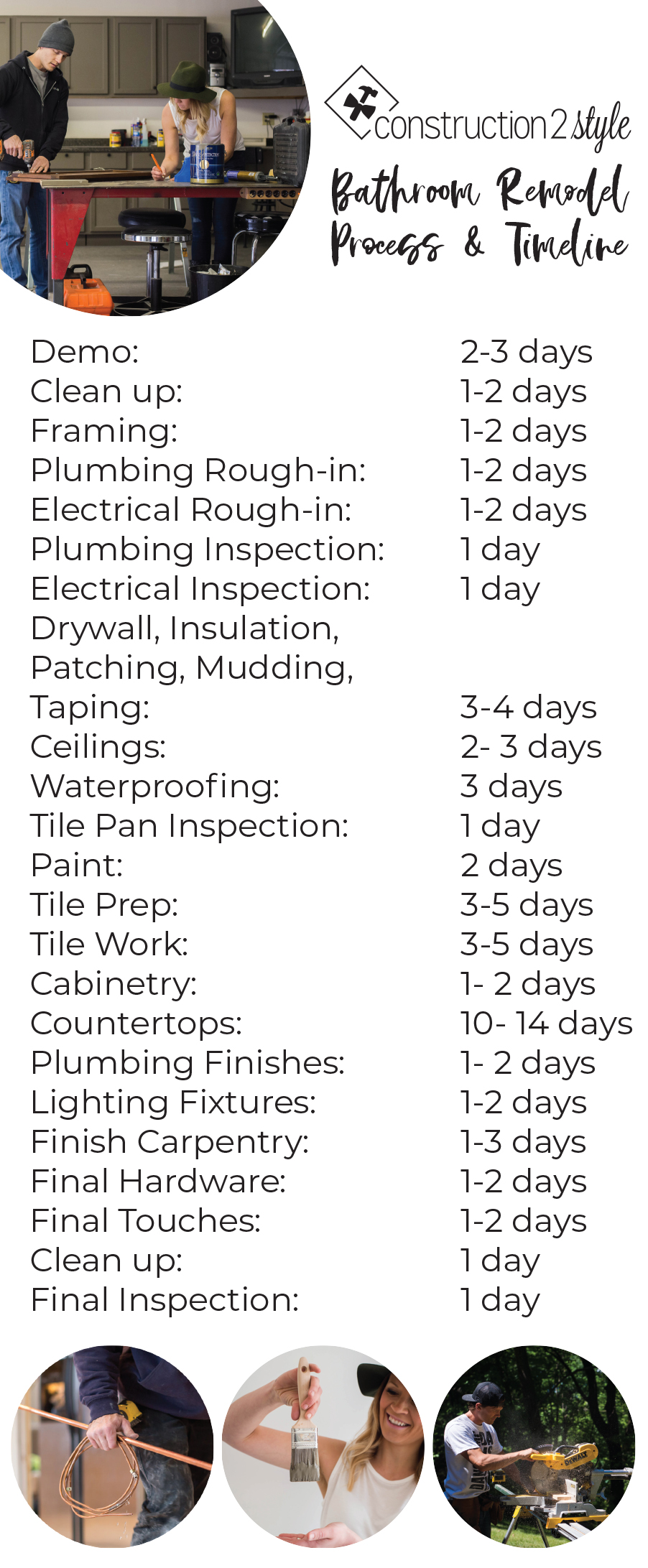

Source : construction2style
Bathroom refit timelines vary dramatically based on the scope of work involved. Understanding these different categories helps you choose the right approach for your needs and timeline constraints.
Simple facelift renovations completed in 1-3 days
Facelift renovations focus on cosmetic improvements without major structural changes. These projects typically involve retiling existing surfaces, updating fixtures, and refreshing the overall appearance. Such work can often be completed within a long weekend, making it perfect for busy families who cannot afford extended disruption.
Full bathroom refits requiring 6-7 working days
- Complete removal of existing tiles and fixtures
- New plumbing connections and electrical work
- Full retiling of walls and floors
- Installation of new bathroom suite and accessories
- Final finishing touches and thorough cleaning
Complex refits extending to 3-8 weeks duration
Extensive renovations involving structural modifications, complete plumbing relocation, or luxury installations require significantly longer timeframes. These projects often include planning permission, building regulations compliance, and multiple specialist trades working in sequence. The complexity justifies the extended timeline through dramatic improvements in functionality and value.
What Happens During Each Stage of Your Bathroom Refit Timeline?

Source : Block Renovation
Breaking down the refit process into distinct phases helps you understand where time gets allocated during your renovation project. Each stage serves specific purposes and contributes to the overall timeline.
Demolition and preparation phase duration
Initial demolition typically requires 1-2 days for standard bathrooms. This phase involves careful removal of existing tiles, fixtures, and fittings whilst protecting surrounding areas from damage. Proper preparation saves time during subsequent installation phases by ensuring clean, level surfaces for new materials.
Plumbing and electrical work timeframes
- Rough plumbing modifications take 1-2 days depending on complexity
- Electrical upgrades for lighting and ventilation require additional day
- Waterproofing application needs 24-48 hours curing time
- First fix inspections may add scheduling delays
Wall and floor tiling installation periods
Professional tilers typically complete wall tiling in 2-3 days for standard bathrooms, followed by floor installation requiring an additional 1-2 days. Grout curing periods add 24 hours between tiling completion and final fixture installation. Complex patterns or natural stone materials may extend these timeframes by 30-50%.
Final fitting and finishing touches schedule
Installation of sanitaryware, mirrors, and accessories usually requires 1-2 days once tiling is complete. Final touches include sealant application, thorough cleaning, and quality checks. Many contractors schedule a brief return visit after several days to address any minor adjustments or touch-up work needed.
How Can You Speed Up Your Bathroom Refit Without Compromising Quality?

Source : haus & hand
Strategic planning and preparation can significantly reduce your bathroom refit timeline whilst maintaining high standards. Smart approaches focus on eliminating delays and optimising workflow efficiency.
Pre-ordering tiles and materials before refit begins
Ordering all materials at least 2-3 weeks before work commences eliminates delivery delays that frequently disrupt renovation schedules. This approach also allows time for quality checks and replacements if any items arrive damaged or incorrect.
Choosing experienced local tilers in Bromley and Kent
- Local contractors understand regional building requirements and supplier networks
- Established relationships with local suppliers ensure faster material delivery
- Experienced teams work more efficiently and encounter fewer unexpected issues
- Proximity reduces travel time and allows flexible scheduling adjustments
Planning temporary bathroom arrangements during refit
Advance preparation of alternative washing facilities reduces pressure on contractors to rush completion. Whether arranging gym memberships, staying with family, or setting up temporary facilities elsewhere in the home, removing time pressure allows craftsmen to focus on quality rather than speed.
What Delays Should You Expect During Your Bathroom Refit?

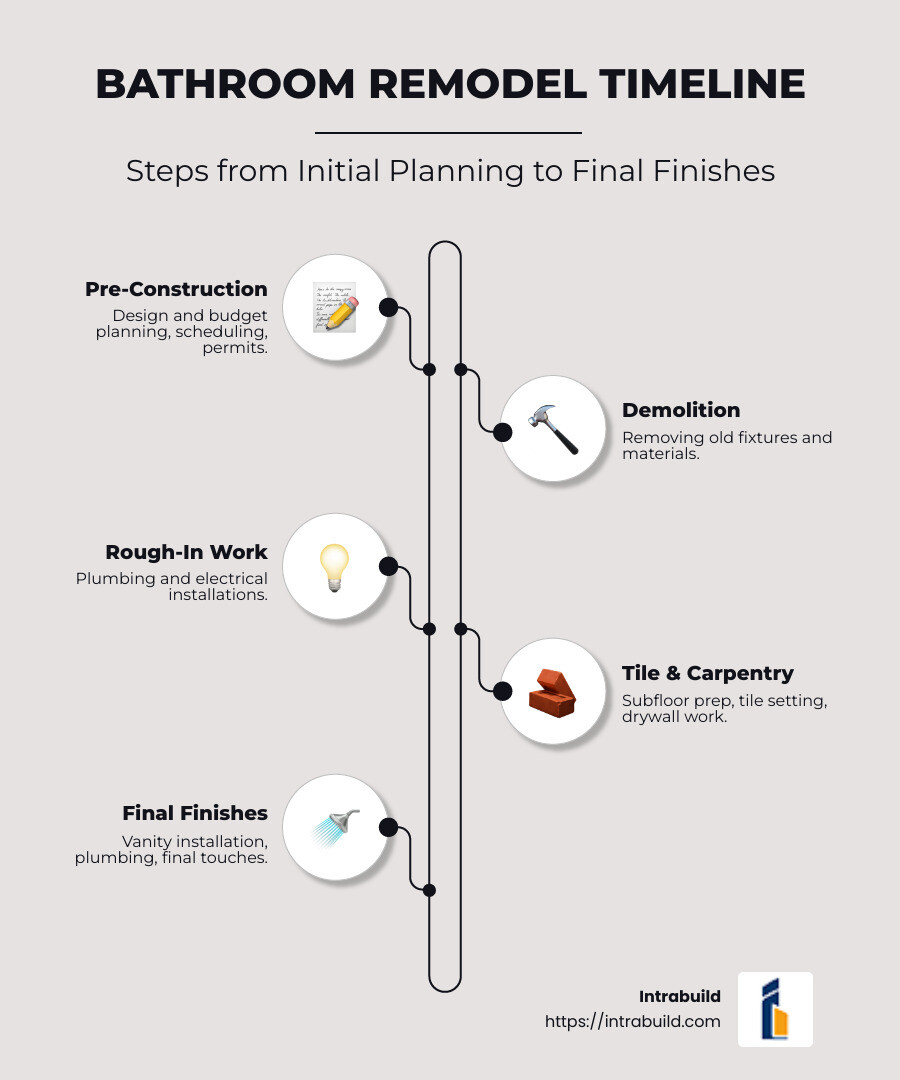

Source : Intrabuild: Leading Design-Build Firm in NYC
Understanding common delay sources helps you plan realistic timelines and avoid frustration during your renovation project. Most delays stem from factors beyond direct contractor control.
Material delivery issues extending refit timelines
Supply chain disruptions can add 1-2 weeks to project timelines, particularly for specialist tiles or imported materials. UK suppliers report increased delivery delays of 15-20% compared to pre-2020 levels due to ongoing logistics challenges. Weather conditions and seasonal demand fluctuations also affect delivery schedules.
Unexpected structural problems discovered during renovation
- Hidden water damage requiring additional repair work
- Outdated plumbing systems needing complete replacement
- Electrical issues requiring rewiring and safety upgrades
- Structural problems affecting wall stability or floor integrity
Building regulation inspections affecting refit schedules
Local authority inspections can add 3-5 working days to project timelines, particularly for electrical work or structural modifications. Scheduling these inspections requires advance notice and coordination with inspector availability. Failed inspections necessitate remedial work and re-inspection, potentially extending timelines by 1-2 weeks.
How Long Will Your Complete Bathroom Refit Actually Take?

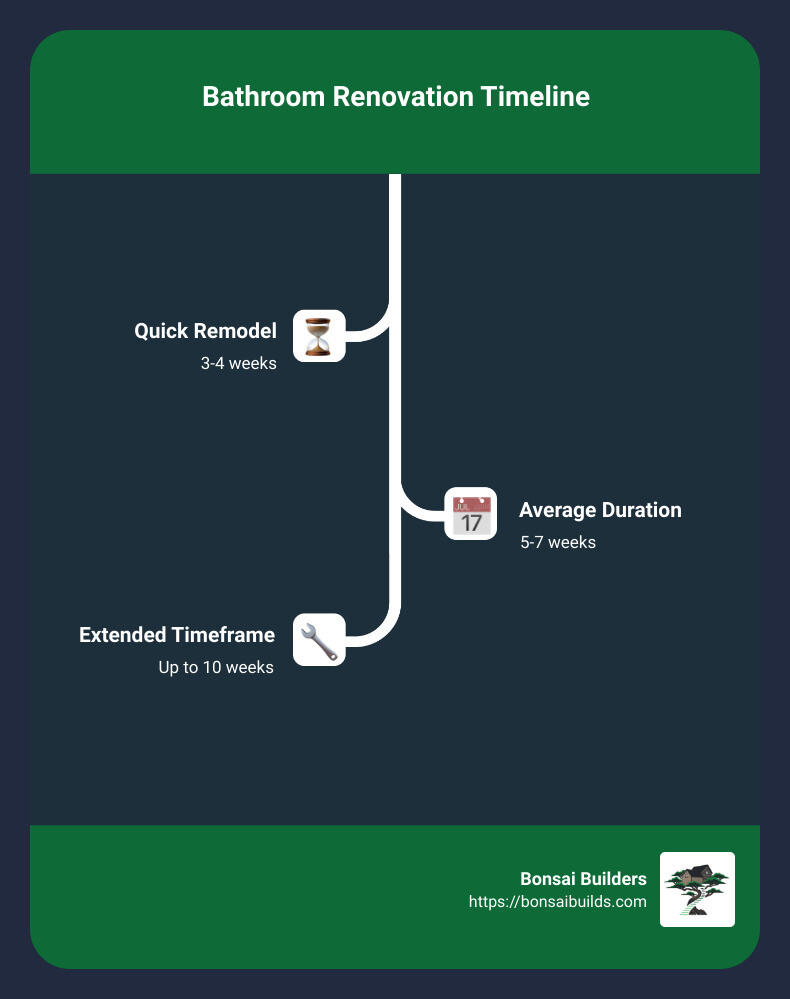

Source : Bonsai Builders
Realistic planning requires honest assessment of your specific circumstances and requirements. Most homeowners benefit from adding buffer time to quoted completion dates to account for unforeseen complications.
Realistic timeframes for different refit scopes
Simple refreshes take 3-5 working days, standard full refits require 6-8 working days, whilst complex renovations extend to 3-8 weeks. These timeframes assume professional installation with readily available materials and no major complications. Single-person contractors working part-time may double these durations.
Buffer time recommendations for smooth project completion
- Add 25% extra time for straightforward refits
- Include 40% buffer for complex renovations involving structural changes
- Plan alternative accommodation for projects exceeding one week
- Schedule completion before important events or deadlines
Next steps for starting your bathroom renovation journey
Begin by obtaining detailed quotes from experienced local contractors who can assess your specific requirements and provide realistic timelines. For inspiration on design choices, explore our comprehensive bathroom tile ideas and consider incorporating walk-in shower ideas to enhance functionality. Quality planning and professional installation ensure your bathroom refit completes on schedule whilst delivering the functional and aesthetic improvements your family deserves. Remember that investing in proper planning and skilled craftsmen pays dividends through reduced stress and superior results.
FAQ
Can you remodel a bathroom for $5000?
Typically, bathroom remodels start at $5,000 and can vary based on the size of your room and the products you choose to update.
How hard is it to refit a bathroom?
A new bathroom installation is definitely not a DIY job. Unless you are a skilled worker yourself, you can easily botch it up. And as a result, the project cost may rise further. Engaging separate tradespersons such as plumbers, electricians, and plasterers is a good option.
How much does it cost to refit a bathroom?
If you plan to replace existing fixtures and fittings without altering the layout, the cost typically ranges from £3,000 to £7,000. Refitting a bathroom involves updating key components such as tiling, fixtures, and sometimes plumbing and electrical systems.
How long does it take to replace drywall in bathroom?
Insulation, Drywall and Painting: One to four days This might be a simple one-day job if all you need is paint. If you remove drywall and need to insulate, hang new drywall and prep the drywall for painting, allot one to two days based on the size of the bathroom. Drywall is a fast job for most pros.
